Why does underfloor heating need commissioning?
Commissioning confirms the pipework is sound, the loops are balanced and the controls are set correctly, so the system delivers even, efficient heating rather than hot and cold spots.
An underfloor heating commissioning certificate records that a wet underfloor heating system has been pressure tested, balanced and commissioned correctly before handover. It confirms the loops, manifold and controls are set up to deliver even, efficient heating.
Wet systems need careful commissioning, including a pressure test of the pipework, balancing of the loop flow rates at the manifold and a controlled screed drying and warm-up process. Skipping these steps can lead to poor performance or damage to the screed.
TradePlanr lets you record the pressure test, flow rates, manifold settings and screed commissioning on site and produce a PDF certificate, so the whole process is documented for the customer.
A commissioning certificate should be completed whenever a wet underfloor heating system is installed and brought into service. It is the record that the system was pressure tested and balanced correctly.
Where the pipework is embedded in screed, a controlled screed drying and warm-up procedure is needed before the system is used normally, and the certificate records that this was carried out.
The completed certificate is handed to the customer and kept with the system documentation, and may support warranty cover and future servicing.

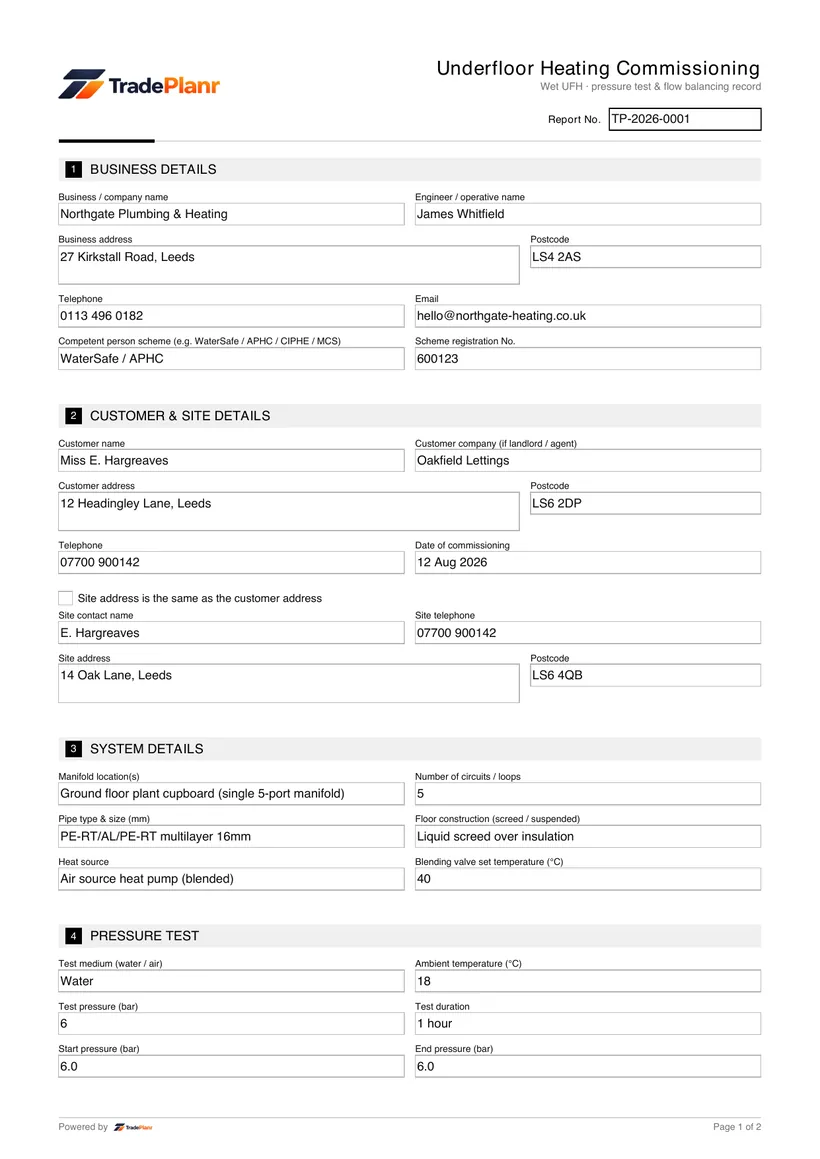

Record the property, the number of zones and loops and the manifold arrangement, so the certificate reflects the installed system.

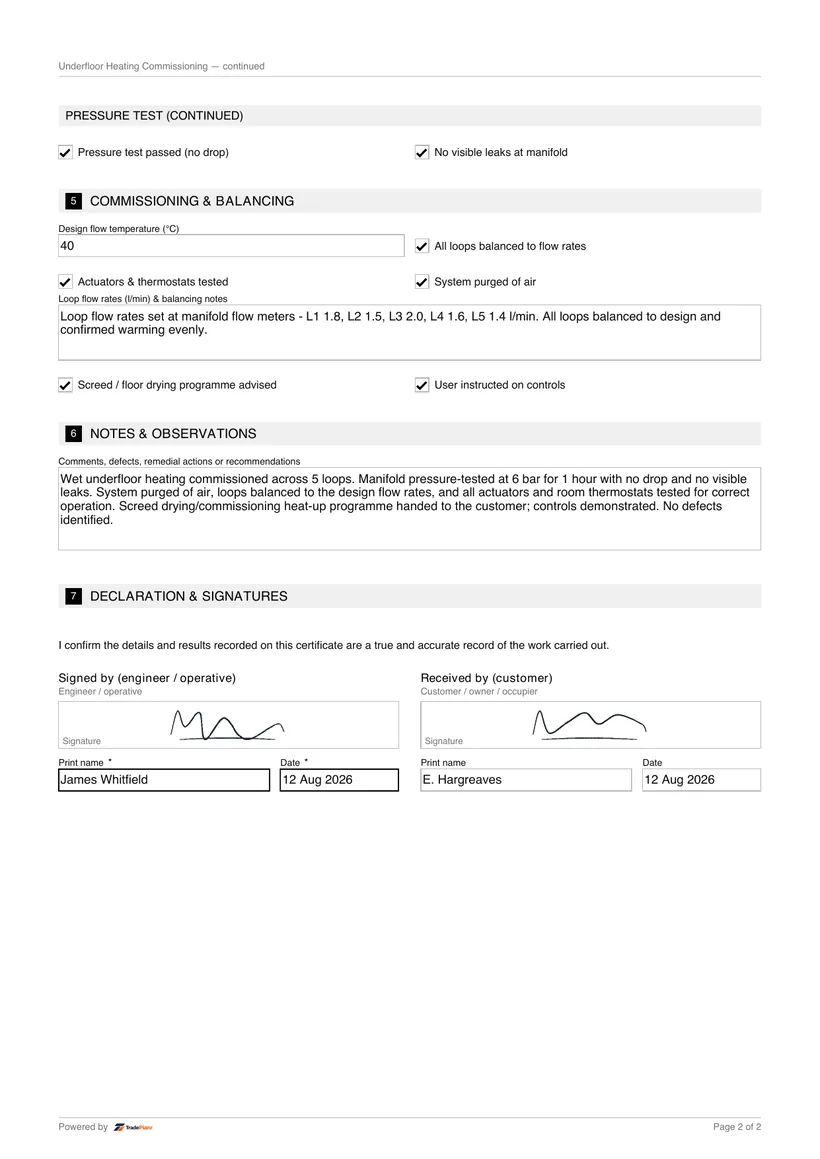

Log the test pressure, the duration held and the result, confirming the pipework is sound before the floor finish or screed is applied.
Record the loop flow rates, balancing settings, pump and blending valve settings and the zone controls, confirming the system is balanced for even heat.
Capture the signature, generate the PDF commissioning certificate and store it against the job, ready to hand over with the screed warm-up guidance.
Commissioning confirms the pipework is sound, the loops are balanced and the controls are set correctly, so the system delivers even, efficient heating rather than hot and cold spots.
Balancing sets the flow rate through each loop at the manifold so that every zone receives the right amount of heat. It is a key part of commissioning a wet underfloor system.
Where pipework is set in screed, a controlled drying and warm-up process avoids cracking and damage. The certificate records that the correct commissioning procedure was followed.
Yes. TradePlanr lets you record the pressure test, flow rates and manifold settings, capture the signature and produce the PDF at the property.
The pressure/soundness test record for new or altered water and heating pipework.
The Benchmark commissioning checklist completed when a boiler or heating system is installed.
The record of a chemical or power flush and inhibitor dose to BS 7593.
No card required · Free to start · iPhone, Android & web
